Standard Form 1405 at a glance
What it is: Standard Form 1405 is the Pre-Award Survey of Prospective Contractor (Production), prescribed by GSA-FAR (48 CFR) 53.209-1(c).
Who signs: Under 3. SURVEY MADE BY and 4. SURVEY REVIEWING OFFICIAL, enter a. SIGNATURE AND OFFICE (Include typed or printed name).

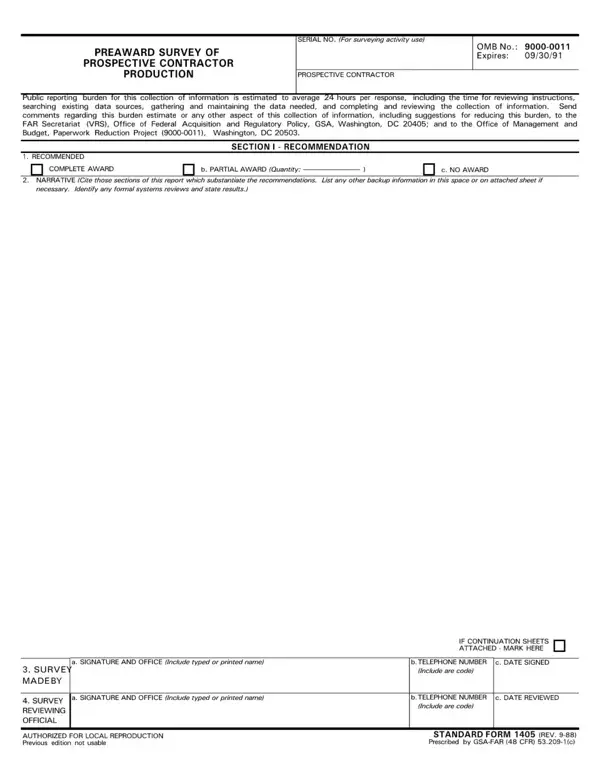

A filled-in Standard Form 1405 example: a partial award recommended on a pre-award survey

How to fill out Standard Form 1405, box by box
Serial number and prospective contractor
Recommended
Narrative and continuation sheets
More rules for Standard Form 1405
The form is authorized for local reproduction, and the previous edition is NOT usable.
Under SECTION II - PLANT FACILITIES, enter 1. SIZE OF TRACT, 2. SQUARE FEET UNDER ROOF, 3. NUMBER OF BUILDINGS and 4. DESCRIPTION AND TYPED OF BUILDING(S).
Mark OWNED or LEASED (Give expiration date).
Under 6. MISCELLANEOUS PLANT OBSERVATIONS, mark YES or NO and explain any item marked "NO" on an attached sheet.
Section III - Production Equipment has columns for quantity required for proposed contract, total quantity required during life of proposed contract, quantity on hand, quantity short (Column (c) minus (d)), source, if not on hand, verified delivery date and condition.
Under LIST MAJOR EQUIPMENT REQUIRED, include condition as Good (G), Fair (F) or Poor (P) and annotate in column e.
Under SECTION IV, 1. PARTS/ MATERIAL/SUBCONTRACTS WITH LONGEST LEAD TIME OR CRUCIAL ITEM, enter the DESCRIPTION, SOURCE and VERIFIED DELIVERY DATE TO MEET PRODUCTION.
Under 2., describe the material control systems, indicating whether it is currently operational, and evaluate its ability to meet the needs of the proposed acquisition.
Under SECTION V - PERSONNEL, 1. NUMBER AND SOURCE OF EMPLOYEES, enter the NUMBER ON BOARD, ADDITIONAL NUMBER REQUIRED, AVAILABLE? (YES or NO) and SOURCE by TYPE OF EMPLOYEES: a. SKILLED PRODUCTION, b. UNSKILLED PRODUCTION, c. ENGINEERING and d. ADMINISTRATIVE, then e. TOTAL(Lines A thru D).
Under 2. SHIFTS ON WHICH WORK IS TO BE PERFORMED, mark FIRST, SECOND or THIRD.
Under 3. UNION AFFILIATION, enter the AGREEMENT EXPIRATION DATE.
Under 4. Relationship with labor indicates problems affecting timely performance of proposed contract, mark YES or NO. If "Yes," explain on attached sheet(s).
Under SECTION VII - RELATED PREVIOUS PRODUCTION (Government), PAST YEAR PRODUCTION PERFORMANCE has the ITEM NOMENCLATURE, NATIONAL STOCK NUMBER (NSN), GOVERNMENT CONTRACT NUMBER, ON SCHEDULE, DELINQUENT and QUANTITY.
Identify identical item by an asterisk (*) after the Government contract number.
Under SECTION VIII - CURRENT PRODUCTION (Government and civilian concurrent production schedule using same equipment and/or personnel as offered item), list the ITEM(S) and include the Government Contract Number, if applicable. Identify unsatisfactory performance with asterisk (*).
Enter the MONTHLY SCHEDULE OF CONCURRENT DELIVERIES (Quantity) for BEING PRODUCED and PENDING AWARD: 1st 2nd 3rd 4th 5th 6th 7th 8th 9th 10th BALANCE.
Under SECTION IX, ORGANIZATION AND MANAGEMENT DATA, SECTION NARRATIVE: 1. Describe the relationship between management production, and inspection. Attach an organization chart, if available.
In SECTION IX, 2. Describe the prospective contractor's production control system. State whether or not it is operational.
In SECTION IX, 3. Evaluate the prospective contractor's production control system in terms of (a) historical effectiveness, (b) the proposed contract, and (c) total production during performance of the proposed contract.
In SECTION IX, 4. Comment on or evaluate areas unique to this survey (include all special request(s) by the contracting office and any other information pertinent to the proposed contractor item classification).
Sources
[1] Standard Form 1405 (REV. 1/2014), Pre-Award Survey of Prospective Contractor (Production), U.S. General Services Administration (the Official source link on this page).
