Safeguard Properties Winterization Checklist at a glance
What it is: The Safeguard Properties Winterization Checklist and Documentation lists the Contractor Code, Property Address, Date and Employee's Name.
Who signs: As a qualified individual to perform a proper winterization, sign and write the Date.

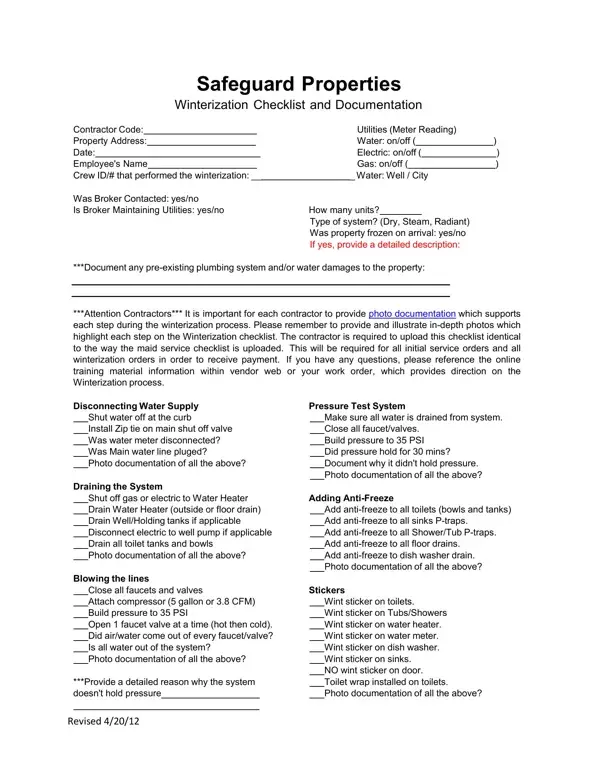

The blank Safeguard Properties Winterization Checklist: print it and complete it by hand

How to fill out Safeguard Properties Winterization Checklist, box by box
Utilities (Meter Reading)
Under Utilities (Meter Reading), write Water: on/off, Electric: on/off and Gas: on/off.
Write the Crew ID/# that performed the winterization.
Write Water: Well / City.
Write yes/no for Was Broker Contacted and for Is Broker Maintaining Utilities.
Write How many units? and Type of system? (Dry, Steam, Radiant).
Write yes/no for Was property frozen on arrival. If yes, provide a detailed description.
Document any pre-existing plumbing system and/or water damages to the property.

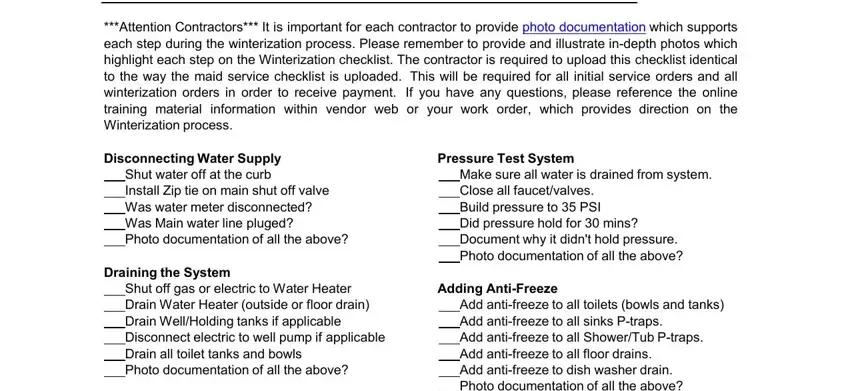

Disconnecting Water Supply
Under Disconnecting Water Supply, shut water off at the curb, install Zip tie on main shut off valve and write yes/no for Was water meter disconnected? and Was Main water line pluged?
Pressure Test System
Under Pressure Test System, make sure all water is drained from system. Close all faucet/valves. Build pressure to 35 PSI. Did pressure hold for 30 mins? Document why it didn't hold pressure.
Draining the System
Under Draining the System, shut off gas or electric to Water Heater. Drain Water Heater (outside or floor drain). Drain Well/Holding tanks if applicable. Disconnect electric to well pump if applicable. Drain all toilet tanks and bowls.
Adding Anti-Freeze
Under Adding Anti-Freeze, add anti-freeze to all toilets (bowls and tanks), all sinks P-traps, all Shower/Tub P-traps, all floor drains and dish washer drain.
Blowing the lines
Under Blowing the lines, close all faucets and valves. Attach compressor (5 gallon or 3.8 CFM). Build pressure to 35 PSI. Open 1 faucet valve at a time (hot then cold).
Stickers
Wint sticker on toilets, Tubs/Showers, water heater, water meter, dish washer and sinks. NO wint sticker on door. Toilet wrap installed on toilets.
If Radiant or Steam Heating System
If Radiant or Steam Heating System: Drain boiler. Loosen bleeder pins to allow draining. Drain expansion tank. Blow heating loops. Pressure test heating system. Wint sticker boiler.
Notify Safeguard (Call from site)
Notify Safeguard (Call from site) If there is a Fire Suppression System.
Notify Safeguard (Call from site) if there is a lawn sprinkler system or if there are unusual circumstances.
Signature
By signing and dating, I take full responsibility for the accuracy and workmanship for completing and documenting a proper winterization.
As a qualified individual to perform a proper winterization, I have photo documented the entire winterization process to support all items are completed per Safeguard Properties guidelines and all supporting documentation for damages and estimates/bids are accurate.
More rules for Safeguard Properties Winterization Checklist
It is important for each contractor to provide photo documentation which supports each step during the winterization process.
The contractor is required to upload this checklist identical to the way the maid service checklist is uploaded. This will be required for all initial service orders and all winterization orders in order to receive payment.
If you have any questions, please reference the online training material information within vendor web or your work order, which provides direction on the Winterization process.
The form is Revised 4/20/12.
I understand that any missed, false and/or inaccurate information will result in total ownership of the plumbing system and all repairs to the system will be at my cost to achieve a sound certified working plumbing system.
